A commercial microgrid can look simple on a system diagram.
Solar panels generate electricity. Batteries store it. An EMS controls the system. The grid or a generator provides support when required.
The real design work, however, starts before any of those components are selected.
A factory with a 500 kW peak demand does not automatically need a 500 kW battery. A building that consumes 2,000 kWh per day does not automatically need a 2,000 kWh energy storage system. And installing more solar panels does not necessarily produce a better microgrid.
The right configuration depends on how electricity is actually used.
For a commercial or industrial project, a practical design usually follows five steps:
- Analyze the load profile
- Determine the appropriate solar capacity
- Select battery power and energy capacity
- Configure the EMS operating strategy
- Design the backup and grid interaction strategy
The sequence matters.
If the load analysis is wrong, the solar sizing may be wrong. If the solar sizing is wrong, the battery may be oversized or underused. If the battery is selected without a clear EMS strategy, a technically capable system may still deliver poor economic performance.
This guide explains how to approach commercial microgrid design from a system perspective.

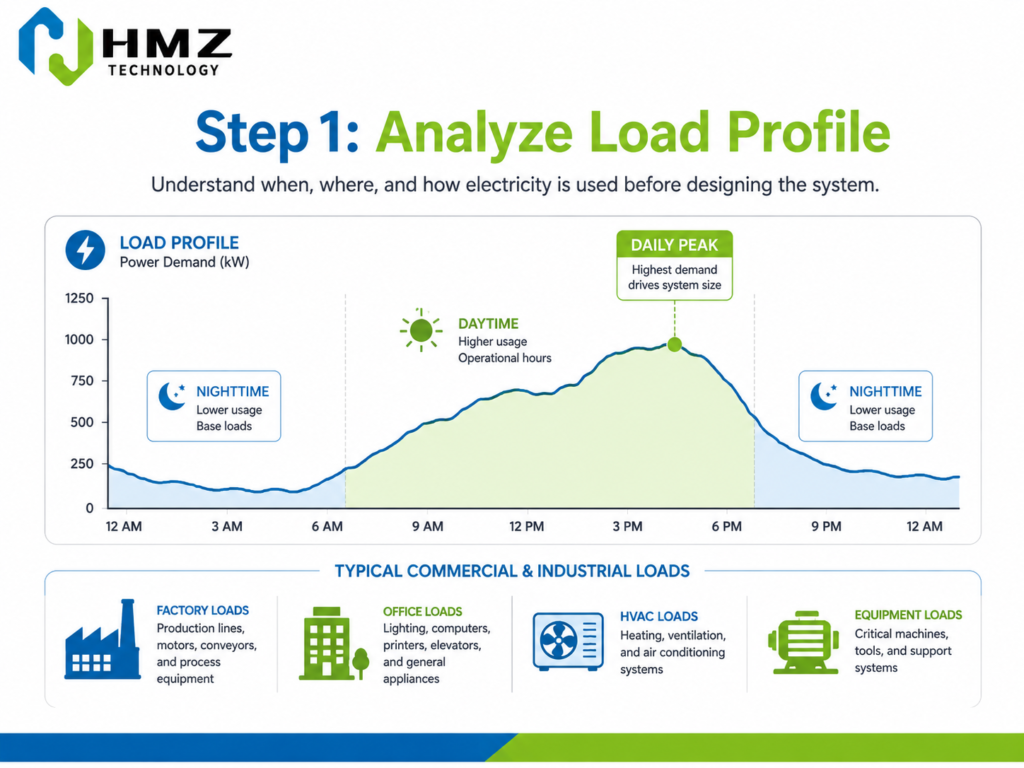

Step 1: Analyze the Load Profile
The first question in a microgrid project should not be:
“What battery should we use?”
It should be:
“How does this site consume electricity?”
This is the foundation of the entire design.
A monthly electricity bill tells you how much energy was consumed, but it does not tell you enough about when the energy was used.
For microgrid design, the load profile matters much more.
What information should be collected?
At a minimum, the project team should understand:
- Daily electricity consumption
- Maximum demand
- Daytime and nighttime load
- Working hours
- Weekend operation
- Seasonal changes
- Large motor or equipment startup loads
- Critical and non-critical loads
- Future expansion plans
For industrial projects, 15-minute or 30-minute interval data is far more useful than a single monthly kWh figure.
Consider two factories that both consume 3,000 kWh per day.
Factory A operates mainly from 8:00 a.m. to 5:00 p.m.
Factory B operates 24 hours a day.
Their daily energy consumption may be identical, but their ideal solar and battery configurations will be very different.
Factory A may be able to consume a large percentage of solar production directly.
Factory B may need significantly more energy shifting because a large part of its electricity demand occurs after sunset.
Peak power also matters
Energy consumption and power demand are two different things.
The load profile should identify not only how many kWh the site consumes, but also how many kW it may require at any one moment.
A facility may normally operate at 300 kW but briefly rise to 500 kW when several machines start together.
If the battery is expected to support that peak, its PCS and discharge capability must be designed accordingly.
Separate critical loads from normal loads
This becomes especially important when backup power is one of the project objectives.
A factory may have a total load of 600 kW, but perhaps only 150 kW is considered critical during a grid outage.
Critical loads might include:
- Control systems
- Refrigeration
- Servers
- Communication equipment
- Security systems
- Essential production equipment
Backing up the entire facility and backing up only critical loads are two very different design requirements.
Correct load classification can significantly reduce unnecessary battery investment

Step 2: Determine the Solar PV Capacity
Once the load is understood, the next question is:
How much solar generation can the site actually use?
This is more important than simply asking how much solar can physically fit on the roof or available land.
A larger PV array may generate more electricity, but that does not automatically mean it creates more value.
The design should consider three things together:
Solar resource + available installation area + load profile
Start with the daytime load
For many commercial projects, the first portion of solar generation should be designed to support the daytime load directly.
If a factory consistently operates at around 400 kW during sunny daytime hours, a meaningful portion of its solar generation may be consumed immediately.
Direct solar consumption is usually the simplest energy path:
Solar PV → Load
No battery charge-discharge cycle is required.
What happens when solar generation exceeds the load?
This is where storage becomes important.
If the facility has low demand at midday but a large PV array, excess solar energy may need to be:
- Stored in batteries
- Exported to the grid where permitted
- Curtailed if neither option is available
A microgrid should therefore be designed around the expected energy flow, not only around installed PV capacity.
Avoid designing solar in isolation
One common mistake is to design the solar system first and think about batteries later.
A better approach is to model the system together:
- What portion of solar will be consumed directly?
- How much excess solar will be available for charging?
- How often will the battery reach full charge?
- How much energy will still be required after sunset?
- Is export to the grid permitted?
The answers determine whether additional PV capacity is useful or simply creates surplus generation with limited value.

Step 3: Select the Battery Power and Energy Capacity
Battery sizing is often the most misunderstood part of commercial microgrid design.
Customers frequently ask:
“How many kWh of batteries do I need?”
But battery selection has two dimensions:
Power — kW
Power determines how much electricity the battery can supply at one moment.
Energy — kWh
Energy determines how long that power can be supplied.
For example, two projects may both use a 250 kWh battery, but they may require completely different PCS power ratings.
One project may use the battery mainly for peak shaving.
Another may require backup power for several hours.
The battery capacity is similar, but the operating objective is different.
Battery sizing should start with the application
Ask what the battery is expected to do.
Peak shaving
If the objective is reducing a short demand peak, power may be more important than long discharge duration.
Solar energy shifting
If the objective is storing midday solar energy for evening use, usable kWh becomes more important.
Backup power
If the objective is supporting critical loads during outages, both required power and backup duration matter.
Hybrid generator operation
If the project combines solar, battery and diesel generation, the battery may also be used to reduce generator runtime and avoid inefficient low-load operation.
Do not size the battery from average consumption alone
Suppose a facility uses 2,400 kWh per day.
Dividing that figure by 24 hours gives an average load of 100 kW.
But the actual facility may operate between 40 kW and 300 kW throughout the day.
Designing the battery around the 100 kW average alone would miss the real operating conditions.
The load curve matters.
Keep usable energy in mind
The nominal battery capacity is not always the same as the energy available to the load.
Actual usable energy is affected by factors including:
- State-of-charge operating window
- Depth of discharge
- Conversion losses
- Battery reserve requirements
- Temperature
- Aging
- EMS strategy
A good design keeps some operating margin rather than assuming every nominal kWh will always be available.

Step 4: Configure the EMS Operating Strategy
Solar panels generate energy.
Batteries store energy.
But the EMS determines how the system behaves.
This is why a microgrid should not be treated as a collection of equipment.
Two projects using similar PV arrays and batteries can perform very differently if their control strategies are different.
What does the EMS manage?
Depending on system architecture, the EMS can monitor and coordinate:
- Solar generation
- Battery state of charge
- Battery charge and discharge power
- Grid import
- Facility load
- Generator operation
- Electricity tariff periods
- Alarm and equipment status
The operating strategy should reflect the customer’s actual priority.
Strategy 1: Maximize solar self-consumption
Typical logic:
Solar supplies the load first.
Excess solar charges the battery.
Stored energy is used later when PV production falls.
This is useful where exporting solar energy has limited value.
Strategy 2: Peak shaving
The EMS monitors grid demand.
When grid demand approaches a preset limit, the battery discharges.
The objective is to keep grid demand below the target level.
Strategy 3: Time-of-use optimization
Where electricity prices vary throughout the day, the system can charge during lower-cost periods and discharge during higher-cost periods.
The economic benefit depends on the local tariff structure.
Strategy 4: Backup reserve
A project focused on energy resilience should not necessarily discharge the battery as deeply as possible every day.
The EMS may reserve part of the state of charge for unexpected outages.
This creates a trade-off:
Using more battery energy for daily cost savings may leave less energy available for emergency backup.
The correct balance depends on the project.
Strategy 5: Generator coordination
For weak-grid or off-grid systems, EMS can coordinate battery and generator operation.
Instead of starting the generator every time demand rises, the battery can handle shorter variations.
The generator can then operate when:
- Battery SOC becomes low
- Solar generation is insufficient
- Load remains high for an extended period
This can reduce unnecessary generator runtime.

Step 5: Design the Backup Strategy
Backup design is where commercial microgrid projects often become much more application-specific.
The phrase “backup power” sounds simple, but the first question should always be:
Backup for what, and for how long?
Identify the required backup load
A customer may say:
“We need the entire factory backed up.”
After reviewing the loads, the project team may find that only a smaller group of systems actually needs uninterrupted power.
Separating critical loads can reduce both battery power and energy requirements.
Define the required duration
Backup for 15 minutes and backup for 8 hours are completely different designs.
Short-duration backup may bridge temporary outages.
Long-duration resilience may require:
- Larger batteries
- Additional solar
- Generator support
- Load shedding
Decide whether a generator is required
A commercial microgrid does not always need a generator.
For sites with a relatively reliable grid and short outages, solar plus batteries may be sufficient for the intended purpose.
For remote sites or locations with long grid outages, a generator may still be practical.
The difference is that the generator becomes one part of the microgrid rather than the only backup source.
Plan islanding carefully
A grid-connected solar-plus-storage system does not automatically become a microgrid during an outage.
If the system must continue operating independently from the utility grid, the electrical design must support safe island operation.
That may require:
- Suitable PCS/inverters
- Switching equipment
- Protection systems
- Microgrid controller
- Load management
- Grid reconnection logic
This part of the design should be treated as an electrical engineering requirement, not simply a software setting.

Putting the Five Steps Together
The five design steps are closely connected.
A practical sequence looks like this:
Load Profile Analysis
↓
Solar PV Sizing
↓
Battery Power & Energy Sizing
↓
EMS Strategy
↓
Backup & Grid Strategy
The important point is that these decisions should not be made independently.
Increasing solar capacity may change battery charging requirements.
Increasing battery capacity may change the EMS strategy.
Changing backup duration may change both PCS power and battery energy.
A commercial microgrid is therefore a system design problem, not a product selection problem.
A Simple Commercial Microgrid Example
Consider a factory that currently relies on the grid and a diesel generator.
The facility has rooftop space suitable for solar PV and wants to achieve three goals:
- Reduce daytime grid electricity consumption
- Reduce peak demand
- Keep critical loads running during short outages
The design process would begin with the load curve.
The team would identify:
- Daytime base load
- Maximum demand
- Critical-load power
- Required backup duration
Solar capacity would then be sized to match a useful portion of the daytime load.
Battery power would be selected according to the peak-shaving requirement and critical-load demand.
Battery energy capacity would be selected based on the amount of solar energy shifting and the desired backup duration.
Finally, the EMS would coordinate:
- Solar priority
- Battery charging
- Peak shaving
- Backup reserve
- Grid interaction
The final system might be smaller or larger than the customer originally expected.
That is exactly why the design should come before equipment selection.
Common Mistakes in Commercial Microgrid Design
Choosing Battery Capacity Before Studying the Load
A large battery is not automatically a better battery.
If the energy is rarely used, the investment may not create enough value.
Looking Only at kWh and Ignoring kW
A battery may have enough stored energy but still lack sufficient power to support a large load.
Both figures matter.
Oversizing Solar Without Considering Energy Use
Additional solar generation has limited value if the facility cannot consume, store or export it.
Treating EMS as an Optional Extra
In a true microgrid, control strategy is central to system performance.
Designing Backup for Every Load
Separating critical loads can often create a more practical and economical solution.
Ignoring Future Expansion
New production lines, EV chargers or additional buildings may significantly change future load requirements.
A good design should leave room for reasonable expansion.
How HMZ Technology Approaches Commercial Microgrid Projects
At HMZ Technology, commercial microgrid projects are approached from the system level.
The goal is not simply to match a customer with a battery cabinet.
The project starts by understanding:
- Load profile
- Site conditions
- Solar potential
- Grid reliability
- Required backup strategy
- Project objectives
From there, solar PV, battery energy storage and intelligent energy management can be configured around the actual application.
For commercial and industrial projects, HMZ’s energy storage portfolio includes configurations such as:
50kW / 112kWh All-in-One C&I Energy Storage System
Suitable for smaller commercial applications, distributed solar-plus-storage and light industrial projects.
125kW / 241kWh All-in-One C&I Energy Storage System
Designed for larger commercial and industrial energy management applications.
125kW / 261kWh Liquid-Cooled C&I Energy Storage System
Suitable for projects requiring higher energy density, more precise thermal management and more demanding operating conditions.
The right configuration depends on the project rather than a fixed product recommendation.
For larger microgrid projects, multiple energy storage units and other system components may be coordinated as part of the overall architecture.
Commercial Microgrid Design Is About Matching the System to the Business
There is no universal commercial microgrid configuration.
A system designed for a hotel should not automatically be copied for a factory.
A factory microgrid should not automatically be copied for a remote mining site.
The correct design depends on what the customer is trying to achieve.
If the objective is cost reduction, the design may focus more heavily on solar self-consumption, peak shaving and tariff optimization.
If the objective is reliability, backup reserve and critical-load management become more important.
If the site is weak-grid or off-grid, generator coordination and long-duration energy management may become central to the design.
The technology may be similar.
The operating strategy is not.
That is why the first step in commercial microgrid design should always be understanding the project—not selecting equipment.
Conclusion
Designing a commercial microgrid requires more than choosing solar panels, batteries and an EMS.
A reliable system begins with a clear understanding of how the facility consumes electricity.
From there, the design process should follow a logical sequence:
Analyze the load.
Size the solar system.
Select battery power and energy capacity.
Define the EMS strategy.
Design the backup and grid interaction.
When these decisions are made together, a microgrid can help businesses improve renewable energy utilization, control electricity costs and build a more resilient energy system.
At HMZ Technology, we focus on matching solar, battery storage and energy management solutions to real operating conditions rather than applying the same configuration to every project.
Frequently Asked Questions
What information is required to design a commercial microgrid?
The most useful information includes the facility’s load profile, peak demand, daily energy consumption, operating hours, critical loads, grid conditions, available solar installation area and required backup duration.
How do you size a battery for a commercial microgrid?
Battery sizing depends on both required power in kW and required energy in kWh. The correct size depends on whether the battery is mainly used for peak shaving, solar energy shifting, backup power or several functions together.
How much solar PV should a commercial microgrid have?
Solar capacity should be based on local solar conditions, available installation area, daytime electricity demand, battery charging needs and whether excess power can be exported to the grid.
What does EMS do in a commercial microgrid?
EMS coordinates solar generation, battery charging and discharging, grid interaction, facility loads and, where applicable, generator operation according to the selected operating strategy.
Does every commercial microgrid need a diesel generator?
No. Generator requirements depend on grid reliability, backup duration and the importance of critical loads. Some projects can meet their objectives with grid-connected solar and battery storage alone.
Can an existing commercial solar system be upgraded into a microgrid?
In many cases, an existing solar installation can form part of a future microgrid, but compatibility, electrical architecture, inverter configuration, protection and control requirements need to be evaluated before adding battery storage and microgrid functionality.
Build Your Intelligent Energy Future with HMZ
HMZ Technology helps businesses move beyond traditional solar systems by combining solar PV, battery storage and intelligent microgrid control.
Our integrated energy solutions are designed for industrial facilities, commercial buildings and remote energy applications requiring reliable, efficient and flexible power.
Contact HMZ Technology today to explore your next solar storage or microgrid project.
Related Insights from HMZ Technology
Industrial energy management is rapidly evolving. While rooftop solar PV provides an effective way for factories to generate clean electricity, many businesses are now looking beyond solar generation and exploring integrated solutions such as energy storage, intelligent energy management, and microgrid systems.
To better understand how commercial and industrial users can optimize their energy strategy, explore more insights from HMZ Technology’s renewable energy knowledge center, including solar PV solutions, C&I energy storage systems, and practical applications for industrial energy management.
